HERBOLD: West Seattle Bridge, SR 99 ramp update
Fri, 05/05/2023
Information from District 1 City Councilmember Lisa Herbold
Below are a few updates about the West Seattle Bridge and related facilities. First, I’ll start with the good news: the repair of the West Seattle Bridge is functioning as expected.
Last week my office asked SDOT for an update about the condition of the West Seattle Bridge, and ongoing monitoring, including the electronic monitoring system provides ongoing real-time updates.
Here’s what SDOT shared:
“In conjunction with monitoring the data from the structural health instrumentation, we have been conducting quarterly onsite inspections since the bridge has been reopened. The observations from the onsite inspection and review of the data from the monitoring system notes shows no anomalies regarding the expected structural behavior of the bridge. Because of the positive news, we are adjusting our onsite inspections to every six months for the upcoming year. We will continue to evaluate the frequency of the onsite inspection with the goal that the frequency of the inspection will be re-aligned to be consistent with Federal guidelines if the findings from the inspection and data continue to show a normal structural behavior.”
Secondly, my office also requested an update about the implementation schedule for the remaining Reconnect West Seattle projects. Here’s the estimated schedule for the seven projects:
- S Elmgrove St conveyance swale – South Park – should be in construction soon (Q2)
- 14th Ave SW conveyance swale – Highland Park – should be in construction soon (Q2)
- Dallas Ave S corridor project – South Park – at 30% design; construction in 2024 most likely
- 4th Ave SW/SW Roxbury St/Olsen Way SW intersection improvements – Highland Park – Notice to proceed in May (construction starting in May)
- SW Holden St / Highland Park Way SW intersection improvements – Highland Park – Intent to award the project in May; anticipate construction to start a few months after
- Dallas Ave S / 14th Ave S intersection improvements – South Park – advertise before June 1; anticipate construction starting in Q3/Q4 2023
- Duwamish Longhouse signal crossing improvements – W Marginal Way SW – working with BNSF on acquiring comments and permits; intend to complete project in 2023 (construction start unknown)

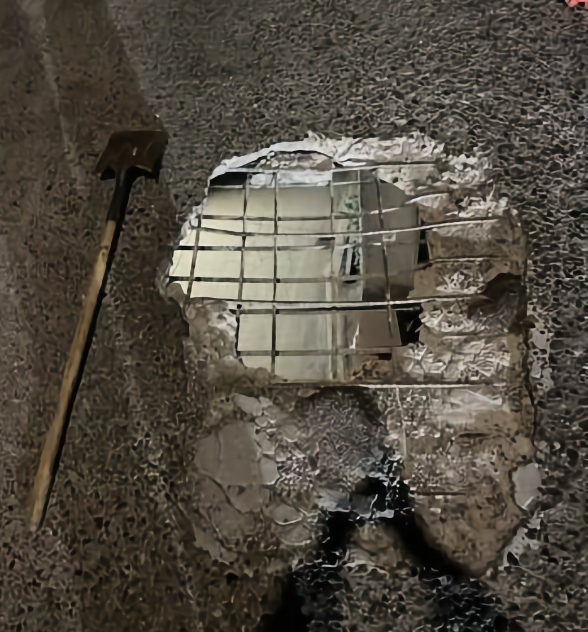

Finally, as many of you are aware, on Tuesday evening WSDOT closed the ramp from the West Seattle Bridge to SR 99 northbound, due to a hole in the road deck. I appreciate SDOT’s rapid response team being the first to arrive on the scene. SDOT staff inspected the hole and alerted WSDOT, which is managing the repair, as the ramp is a state roadway. Here’s an image WSDOT shared Wednesday morning showing the hole, and exposed rebar:

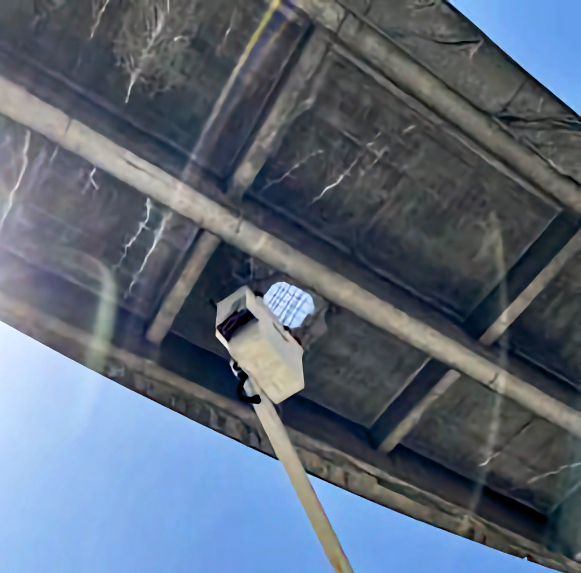

On Wednesday, WSDOT said they were removing concrete around the hole and girders, and once that was done, would begin inserting new rebar, pouring new concrete waiting for it to cure. They also said they expected repairs to take 10 days. Here’s an image shared Thursday:
The ramp was closed for two weeks during April 2022 to repair a similar hole. This ramp remained open during the closure of the West Seattle Bridge and could be accessed from Spokane Street on the east side of the Duwamish.

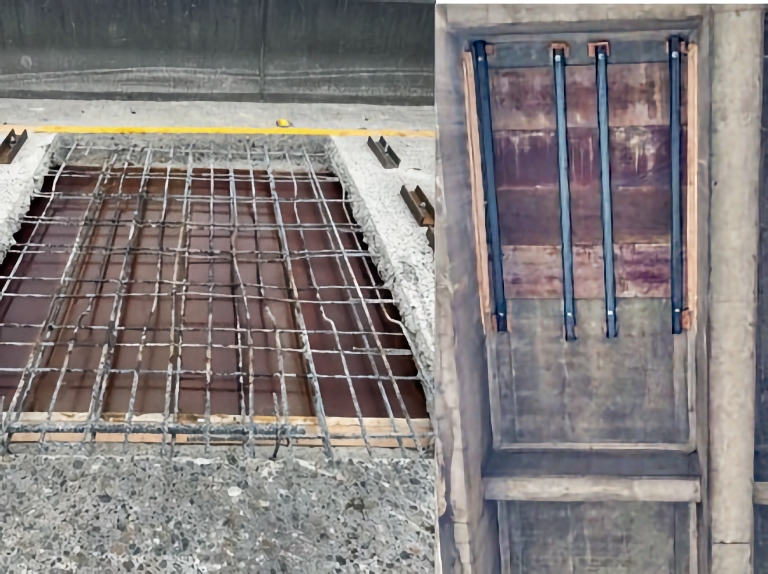

On Wednesday, WSDOT said they were removing concrete around the hole and girders, and once that was done, would begin inserting new re-bar, pouring new concrete waiting for it to cure. They also said they expected repairs to take 10 days. Here’s an image shared Thursday:
Thursday evening WSDOT posted a thread with answers to the three most asked questions they’d received:
- When was this built? Is the ramp safe? When was it last inspected?
It was built in 1959 and last inspected on Aug 9, 2022. It passed that inspection. This damage developed quickly and wasn't present then. All bridges are inspected at least every two years.
- How long has this hole been there? Why did it get so bad?
This damage developed quickly. We prioritize repair work that could be a hazard to travelers, so that's why this damage is being addressed as quickly as possible.
- Why 10 days?
Crews are working quickly and safely to make a lasting repair. They've cleaned the hole's edges to form a good bond. Now they'll repair damaged rebar and pour concrete. Part of the timing is to be sure the concrete is cured to a strength to safely reopen.
On Friday morning WSDOT’s shared this update:

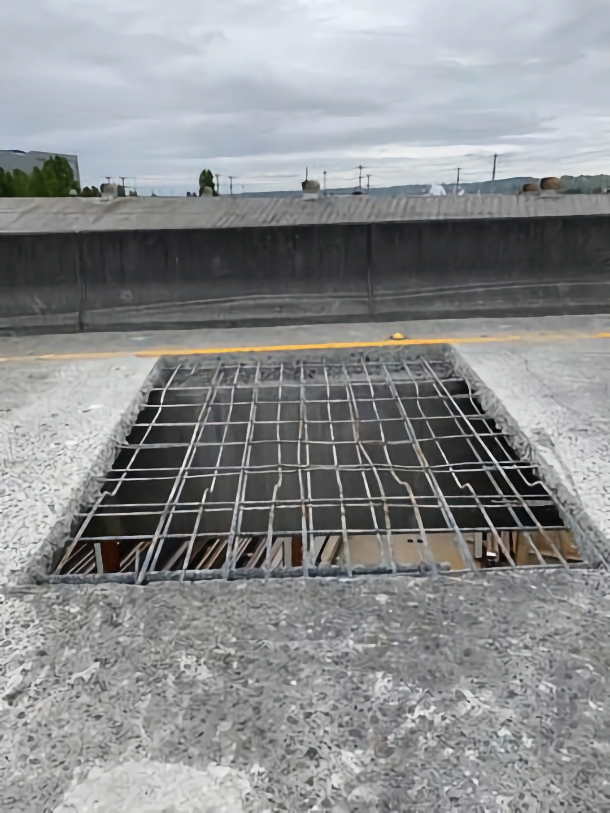

DAY 3 (May 5): Crews continue repair work on SR 99 NB onramp from the West Seattle Bridge. If you look closely, you can see the concrete form and panels in this photo.
Today crews will prep for the next phase of repair & concrete scheduled for delivery tomorrow.
They also shared updated photos from the surface and bottom of the ramp roadway:
SDOT indicated the report they received from WSDOT was that engineers from their Bridge Preservation Office evaluated the site on Wednesday morning to evaluate the damage and assess the best course of repair.
