With major changes coming to the plans previously approved for the West Seattle Link Extension, Sound Transit won't have to file a new or amended Enviornmental Impact Statement.
Following significant modifications to the West Seattle Link Extension (WSLE) plan—including the elimination of the Avalon Station and a massive shift from elevated tracks to a 4,400-foot tunnel—questions have arisen regarding whether Sound Transit must revisit its environmental review process. Despite these high-profile changes, agency officials and federal regulations indicate that the project will proceed under its existing approvals. This is all pending the approval of the changes when the Sound Transit Executive Committee meets in May.
The Power of the Record of Decision
The primary reason a new or amended Environmental Impact Statement (EIS) is not required is that the National Environmental Policy Act (NEPA) process is already complete. The Federal Transit Administration (FTA) issued a formal Record of Decision (ROD) in April 2025, which approves the project and documents that environmental impacts were adequately analyzed.
According to Sound Transit, once a ROD is in place, the project moves into the "final design" phase. Regulatory experts note that agencies routinely handle station sizing, alignment tweaks, and even station eliminations during this stage through internal reevaluations rather than full new EIS documents.
"Refinements" vs. "Substantial Changes"
Under federal law (40 CFR § 1502.9(d)), a Supplemental EIS is only triggered if there are "substantial changes" to a project that create significant new environmental concerns. Sound Transit maintains that the current modifications qualify as final-design refinements that are already "bounded by" the scope of the 2024 Final EIS.
The agency’s reasoning for specific changes includes:

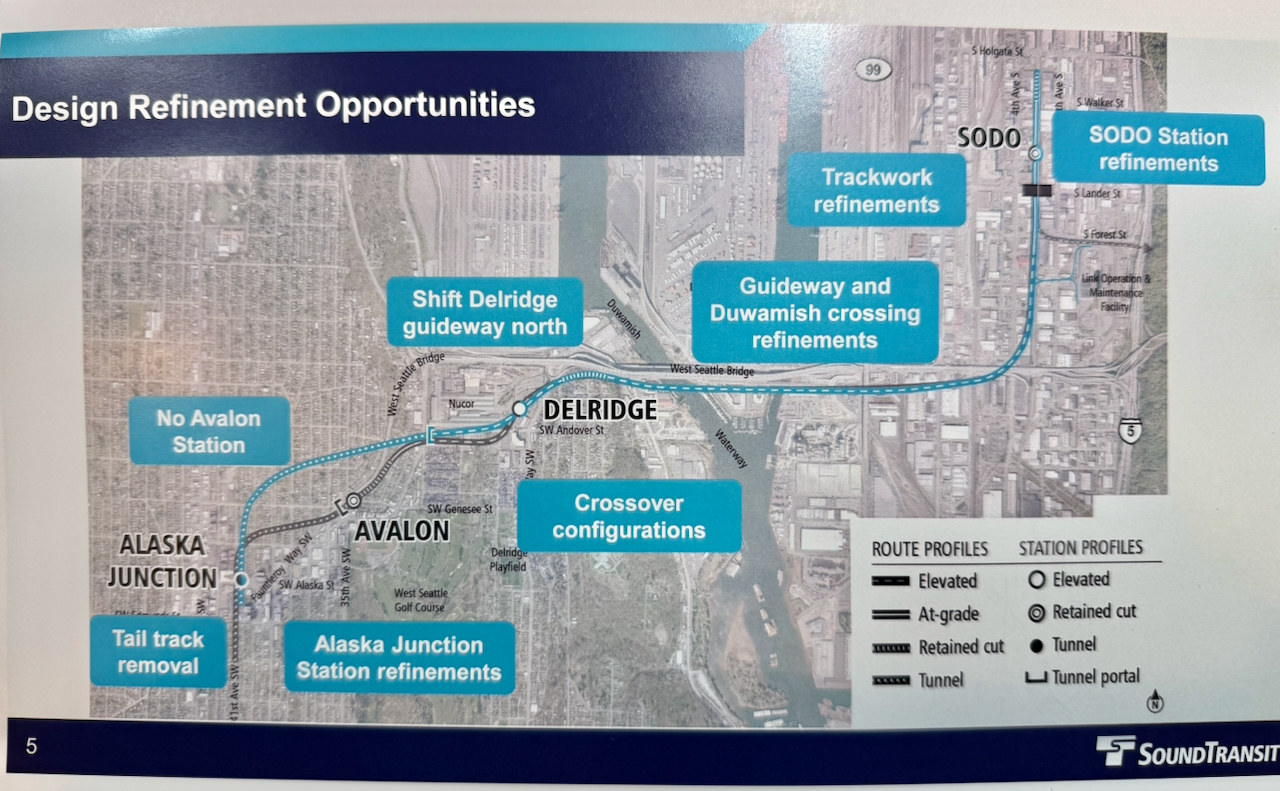

- Avalon Station Elimination & 4,400-Foot Tunnel: The Final EIS had already studied a "no-Avalon" alternative (known as WSJ-6) as a cost-saving measure. The shift to a longer bored tunnel is viewed as a move that reduces environmental impacts, resulting in fewer business and residential displacements and less effect on Longfellow Creek.
- Alaska Junction Station Reconfiguration: Shrinking the station’s concourse and making it shallower (35 feet instead of 60–65 feet) are classified as optimizations to cut costs and reduce property takes.
- Duwamish Bridge Structure: Switching to precast segmental construction is considered a construction method refinement that typically results in a comparable or lower environmental footprint.
Standard Practice for Major Transit
Sound Transit PIO Amy Embysk stated that the agency is working closely with the FTA to ensure all requirements are met, noting, "At this time, we do not anticipate the need for a new or supplemental Environmental Impact Statement".
Because the original Final EIS already explored the key trade-offs—such as tunnel versus elevated segments and the possibility of removing the Avalon station—the current plan does not create "substantial new" effects that would require reopening the full process. This approach is considered standard practice for large-scale transit projects once a federal ROD has been secured.
While technical confirmations will continue during the final design, the 2024 Final EIS and the subsequent 2025 ROD remain the governing environmental documents for the extension
